When can an industrial metal roof be overclad instead of stripped?
What a survey needs to establish before overcladding an industrial metal roof: purlin centres, added weight, wind loading, gutters and future solar loads.

What a survey needs to establish before overcladding an industrial metal roof: purlin centres, added weight, wind loading, gutters and future solar loads.

Download this article. A practical look at the technical factors that determine whether overcladding is a sound long-term option on industrial metal roofs.
Download PDFOn many industrial buildings the existing metal roof is still keeping the weather out, yet it is clearly approaching the end of its serviceable life. Cut-edge corrosion, failed fixings, degraded coatings and rising maintenance costs all signal that action is needed.
The question that almost always follows is whether the roof can be overclad or whether a full strip-and-replace is required. The desire to avoid the cost, disruption and production impact of a full strip-out is understandable. At the same time, no one wants a short-term solution that simply defers a larger problem.
As a specialist commercial and industrial roofing contractor, we regularly help clients and their surveyors decide which route is genuinely viable. This article sets out the practical and technical factors that determine when overcladding is a sound long-term option, and why a thorough survey is essential before that decision is made.
Overcladding means installing a new metal roof system over the top of the existing sheets. The existing roof remains in place and acts as a deck. A new structural spacer system, insulation and outer weather sheet are fixed through to the existing purlins or sheeting rails.

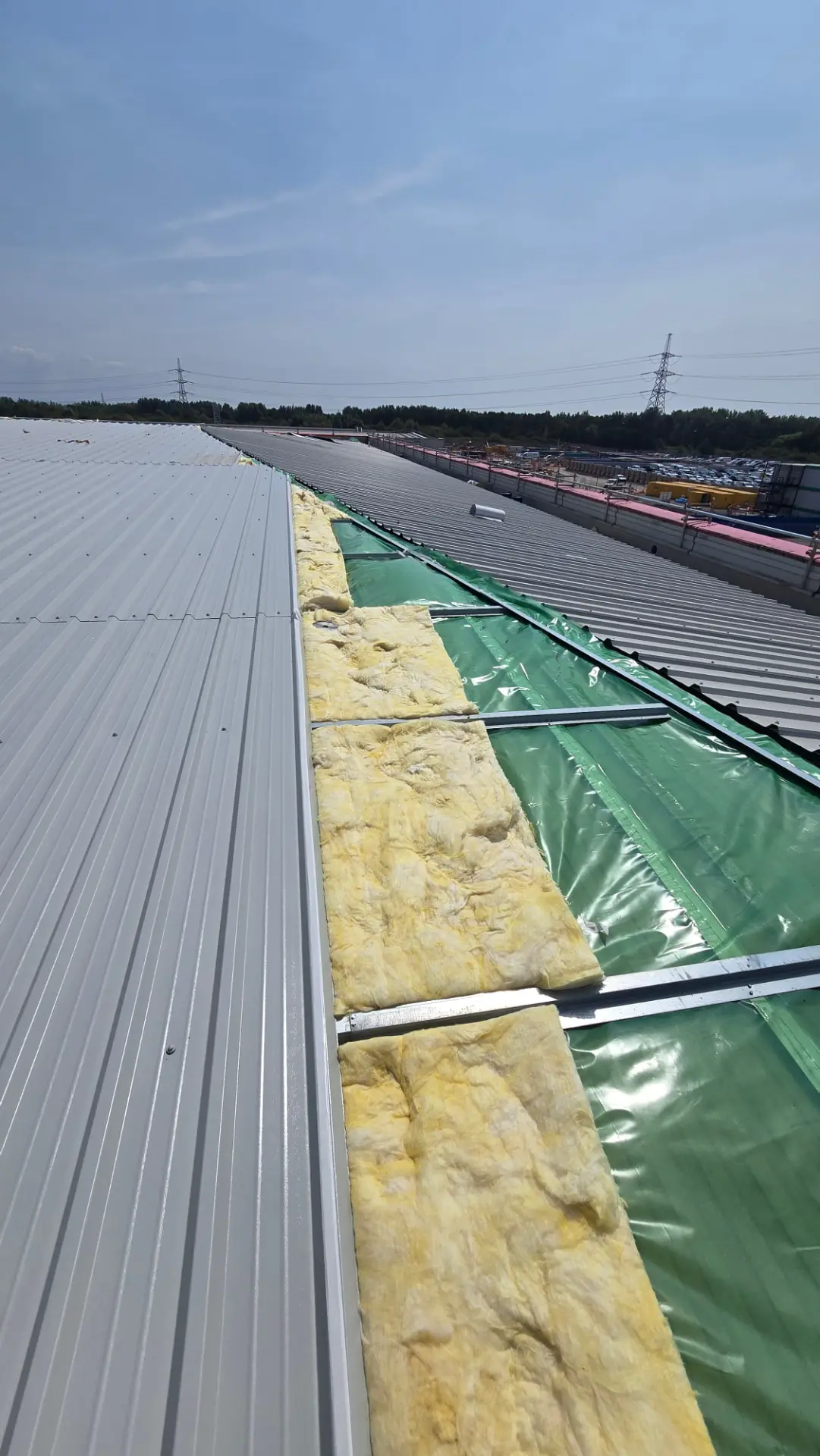

When it is detailed and installed correctly, the result is a new roof with improved thermal performance and a design life comparable to a full replacement, all while the building stays weathertight throughout the works.
Overcladding is most likely to be a robust long-term solution when:

Overcladding should normally be avoided when:
A visual walkover is never enough to decide between overcladding and stripping. The following technical points must be established before any recommendation is made:
Purlin spacing and type directly affect whether the new system can be fixed safely and whether the existing structure can carry the extra load. Steel purlins at wider centres may need additional support or a different spacer system. Concrete purlins require particular care, their condition, reinforcement cover and ability to accept new fixings must be checked. Incorrect assumptions about purlin centres are one of the most common reasons overclad schemes later run into structural or fixing problems.
The weight of the existing roof build-up must be compared with the weight of the proposed overclad system. Both dead load and imposed load need to be considered. Without accurate figures it is impossible to confirm that the primary and secondary structure remain within safe limits.
Any new roof system must be designed for the wind loads applicable to the site. This requires proper calculation, not rules of thumb. The fixing pattern, spacer system and edge details all depend on these figures. A survey that does not feed into wind-load design leaves a critical gap.

Many industrial roofs rely on valley or boundary gutters that were never designed for an overclad build-up. A gutter liner is often required, together with revised upstands and outlets. If the existing gutters cannot accommodate these details, the overclad option may become impractical or disproportionately expensive.
Materials and plant must be distributed so that local overloading of purlins or sheets is avoided during installation. A good survey identifies safe loading-out zones and any restrictions on plant access. This is especially important on older industrial buildings where the existing roof may already be close to its capacity.
If solar is a current or future requirement, the overclad design must allow for the additional load and the fixing of the PV system. Leaving this consideration until later often forces expensive redesign or limits the size of the array that can be installed.

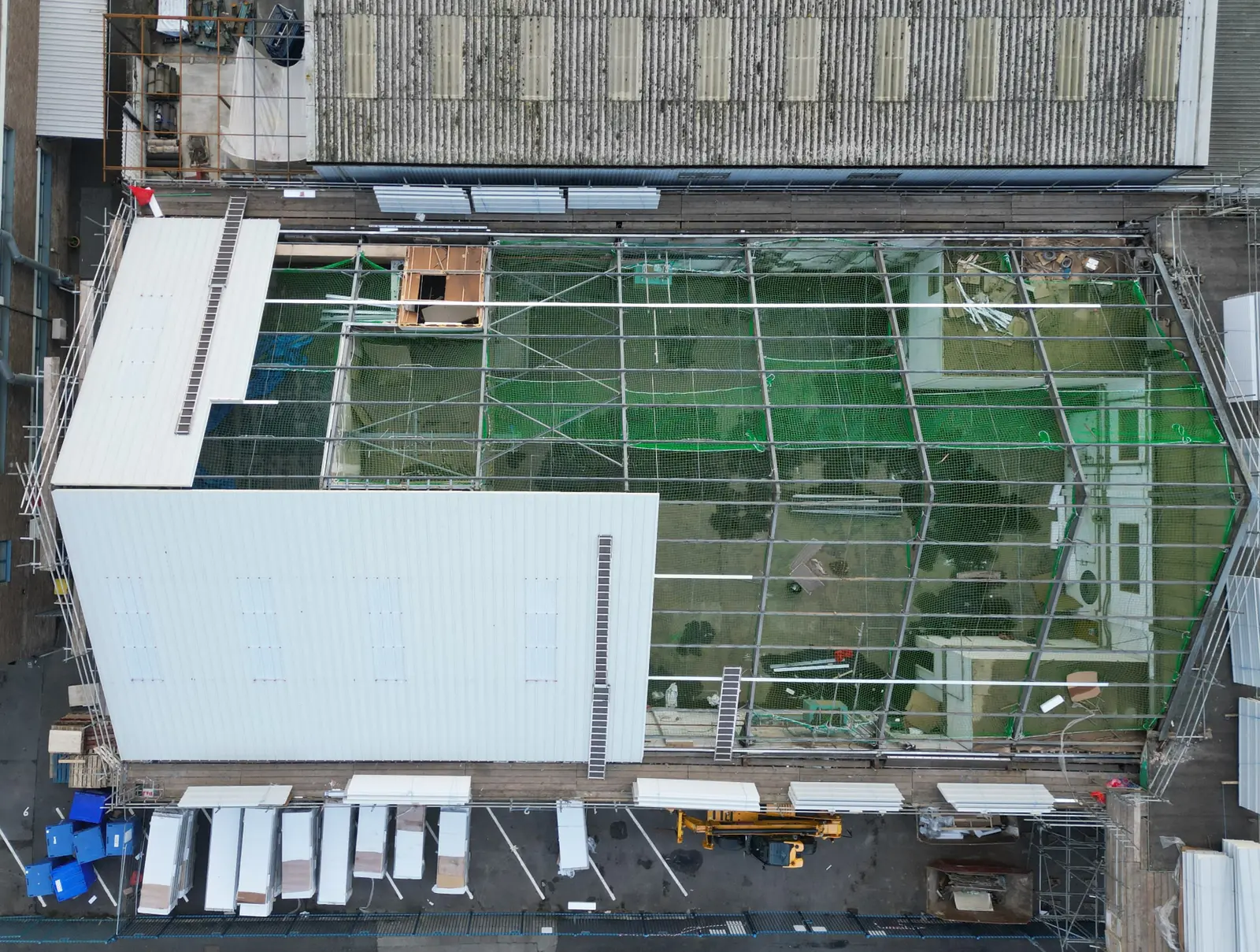

Even when overcladding is technically suitable, the works still need to be phased around production. A thorough survey records operational constraints, preferred working windows, access routes and any areas that cannot be disturbed. This information turns a technical solution into a deliverable programme.
In addition to the usual roof condition information, an industrial metal-roof survey that is intended to inform an overclad-versus-strip decision should specifically record:
Only with this level of information can a clear, defensible recommendation be made. Our roof surveys are structured to capture exactly this evidence, and you can book a roof survey directly.

Overcladding an industrial metal roof can be an excellent long-term solution when the structure, purlins, sheets and interfaces are still capable of supporting a new system. It offers lower disruption to production and avoids the cost and waste of a full strip-out.
It is not a universal answer. Where purlin centres are too wide, concrete purlins are in poor condition, wind loads cannot be satisfied, or gutter details cannot be resolved, a full strip-and-replace remains the more reliable route.
The difference between a successful overclad and an expensive short-term fix is almost always the quality of the early survey. Checking purlin centres and type, existing and proposed weights, wind loading, gutter liners, loading-out restrictions and future solar potential is not optional detail, it is the foundation of a safe and durable decision.
At TRS we regularly help industrial clients and their surveyors work through this decision with clear technical evidence and realistic programme and cost information.
If you would like a second opinion on whether an existing industrial metal roof is suitable for overcladding, feel free to get in touch or book a roof survey.
